Clean electricity
About 121 GWh of solar electricity to the national grid in the first year, over a 25-year design life.
T Resources Limited is developing a 50 MWp solar photovoltaic plant at Kitapilimwa village, to supply clean electricity to Tanzania's national grid through TANESCO.
Representative single-axis tracker plant. Photo: American Public Power Association, Unsplash.The plant combines bifacial modules with single-axis trackers that follow the sun through the day, which raises the energy collected from each module. String inverters convert the output and feed an internal medium voltage network.
The modules receive 2,951 kWh/m² of solar irradiation a year. The energy yield assessment gives an annual performance ratio of 85.1% and 120.95 GWh of net electricity to the grid in year one on a P50 basis.
| Installed capacity | 50 MWp |
|---|---|
| Modules | About 80,000 n-type bifacial modules, 625 Wp each |
| Mounting | Single-axis trackers on driven steel piles |
| Inverters | String inverters, 320 kWac each |
| Irradiation on the modules | 2,951 kWh/m² a year |
| Performance ratio | 85.1% |
| Net energy, year one (P50) | 120.95 GWh |
| Design life | 25 years |
| Construction period | 18 to 24 months from notice to proceed |
| Electricity buyer | TANESCO (memorandum of understanding signed in 2023) |

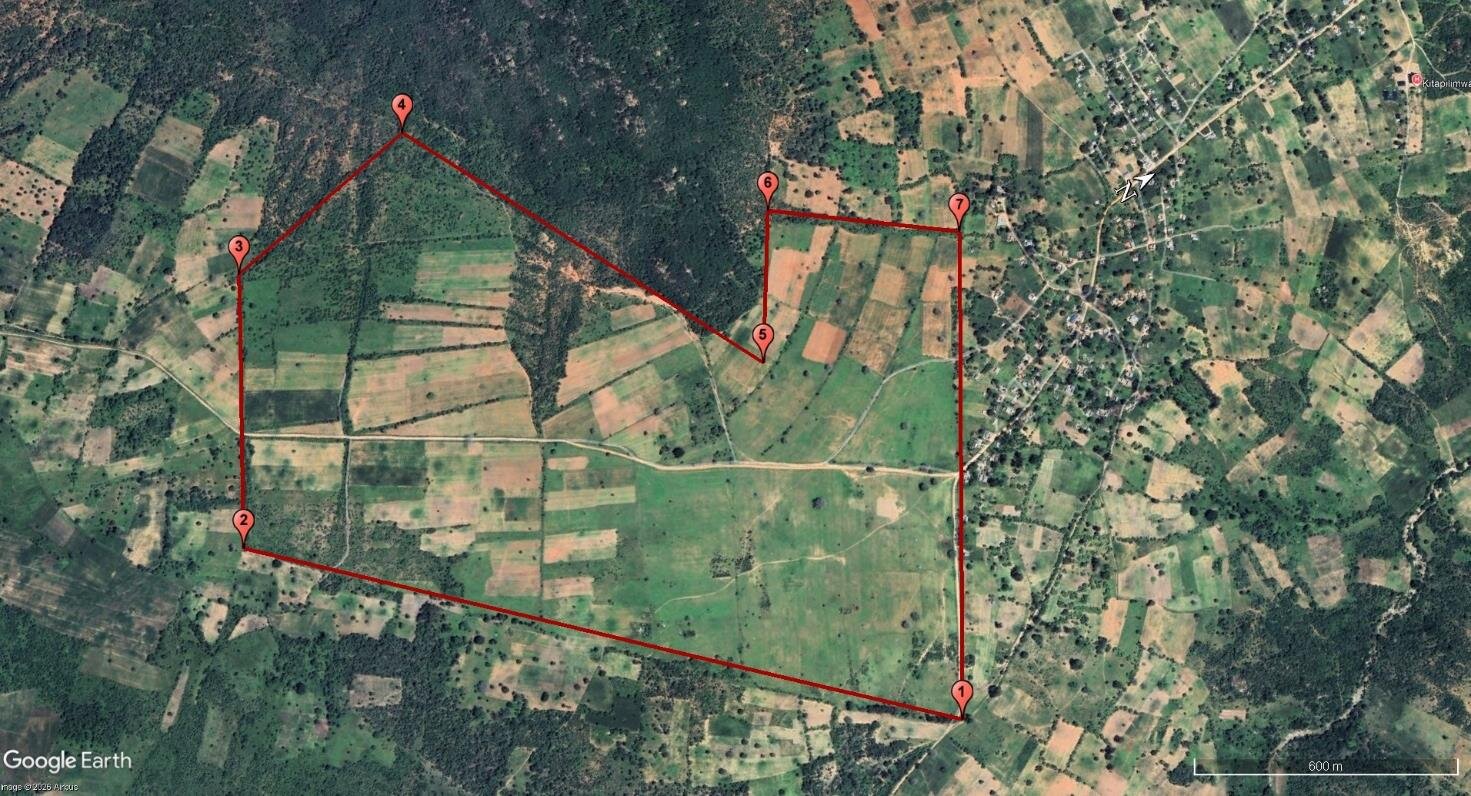

The plant sits at Kitapilimwa village, Kihwele ward, Iringa Rural District (7°39'30"S, 35°39'09"E). T Resources holds the land under a 99-year title deed over 378 acres. The first phase uses 177 acres, which leaves room for a second phase of similar size on the same land.

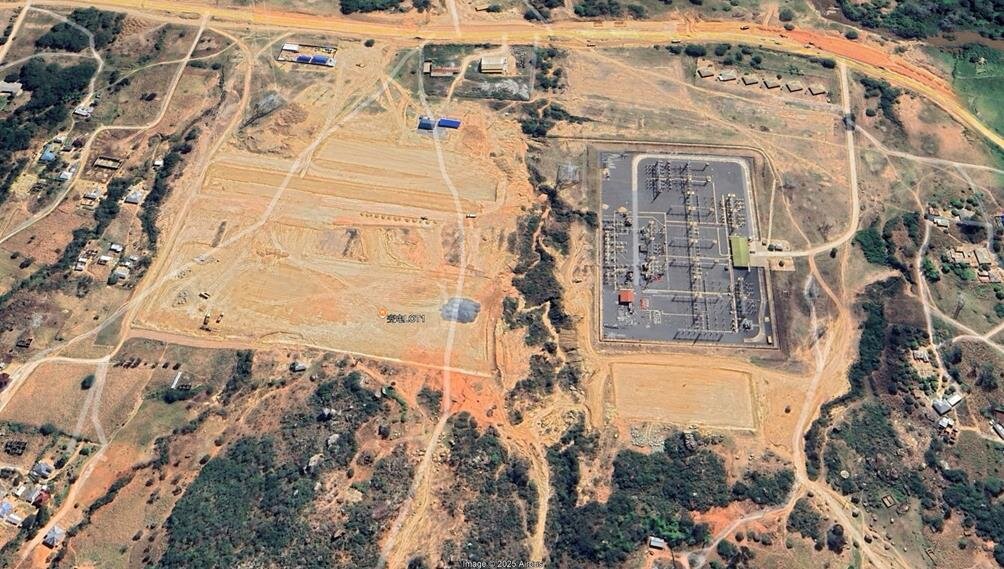

A 25 km, 33 kV double-circuit line will carry the power to the TANESCO Iringa-Tagamenda 400/220/33 kV substation, where a 65 MVA 33/220 kV transformer steps it up to the transmission grid. TANESCO has reviewed the grid interconnection study, and the routing and design of the line are under way.
The project has secured its land, completed its feasibility and grid studies and submitted its environmental assessment. The next steps are the power purchase agreement, the environmental certificate, financial close and the start of construction.

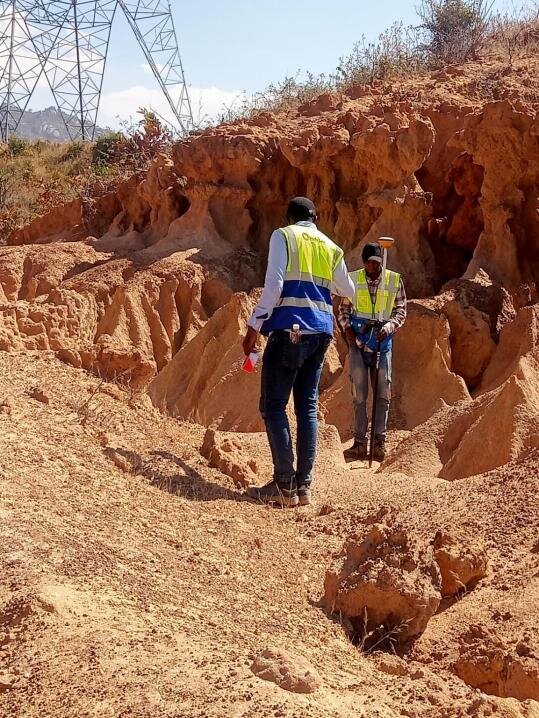

The site, the grid connection point and the survey work for the 33 kV line.

The plant adds new solar capacity to Tanzania's grid and builds local operation and maintenance capability.
About 121 GWh of solar electricity to the national grid in the first year, over a 25-year design life.
50,000 to 55,000 tCO2e avoided each year, 1.2 to 1.4 million tCO2e over the life of the plant.
About 150 jobs during construction, 70% of them local, then permanent operation and maintenance roles, with local staff trained to run the plant.
A Tanzanian company based in Dar es Salaam, led by its CEO, Sarah Saleh Masasi. T Resources owns the project land and leads the development of the Iringa plant.
An independent Italian engineering company specialised in renewable energy. As Owner's Engineer and technical advisor to T Resources, Studio Santi prepared the updated feasibility study, the energy yield assessment and the grid interconnection study, and provides design, design supervision, engineering and construction management for the plant. www.studiosanti.eu
For lenders, investors, contractors and institutions interested in the Iringa 50 MWp Solar Power Project.
